Description:
Bottom of Top Section

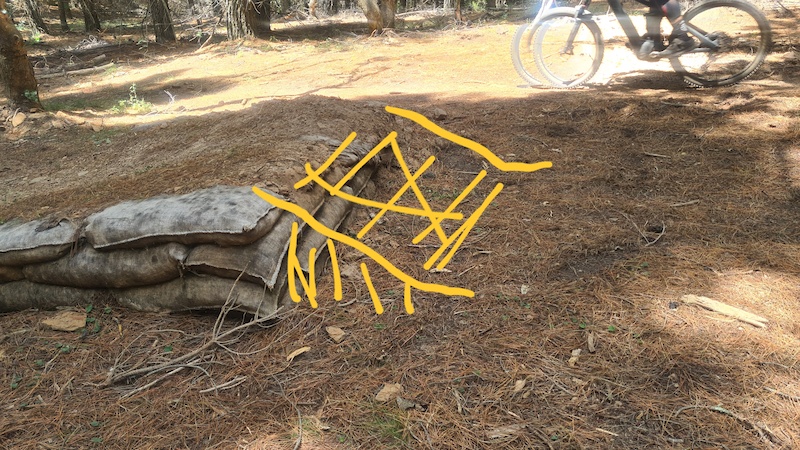

-fix lip edge of lander on gap lander. Add extra soil so it ramps back, this will make it safer someone lands short.

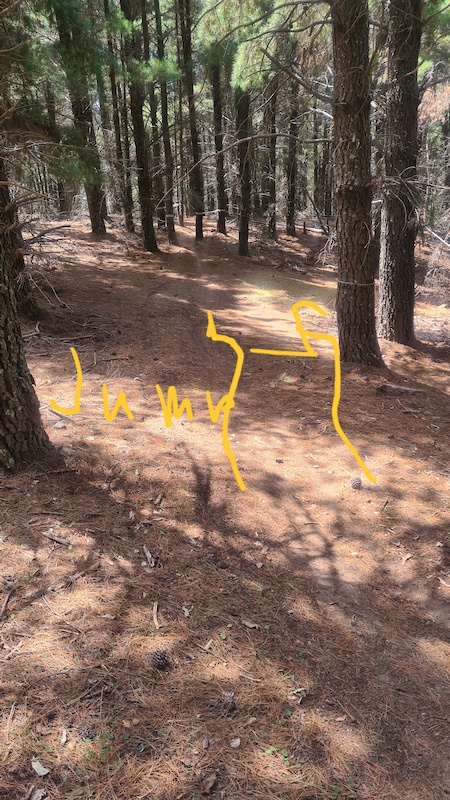

-add jump after gap jump.

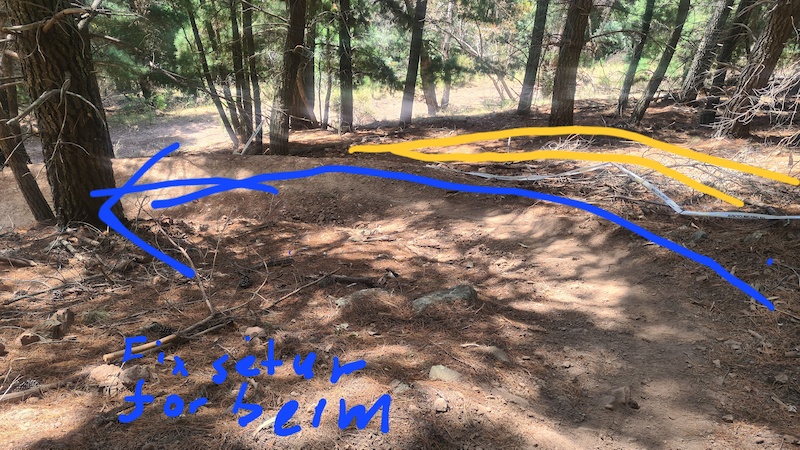

-before road crossing, fix the setup for the berm. You hit it a bit square at the moment, build up the entry on the right so people can start railing it earlier, or push back the middle of the berm.
  • Work Report:
  • trail work done

  • 164 feet worked
  • 2 volunteer attendees
  • 18 volunteer hours
  • 2 total workers
  • 18.0 total work hours
Individual Workers:
turner47 (Scott Turner)
hours: 8
paid: no
TeejayMcSpedden1991
hours: 10
paid: no

Local Weather During Report

  • Summary
    Clear
  • Temperature
    27° (14°/29°)
  • Precip
    0 mm/h
  • Wind
    7.25 km/h
  • Cloud Cover
    2%
  • Humidity
    0.38

Previous Reports

statusdatedescription
Aug 1, 2026 @ 9:32pm
Aug 1, 2026
Repair Gap Jump At bottom of second block it appears pigs 🐖 have been digging in the middle of the gap jump. This risks undermining the jump... view
Aug 1, 2026 @ 9:28pm
Aug 1, 2026
STOP SHORTCUTTING END! Large log required at end of trail to prevent people shortcutting to fire trail. Shortcut has a steep drop onto a... view
Aug 1, 2026 @ 9:21pm
Aug 1, 2026
TRAIL AUDIT 2026 - Direction and rating signs in place at entries. - Trail Filter, (skill check), in place at entries. - Gap jumps in place... view

0 Comments






Official Trail Reporter i

  • Orange Mountain Bike Club - Admin Group
  • OMC
  • 0
  • Share with followers
